“Booking karne ke baad lift kab tak chalu hogi? 2 mahine? 6 mahine?” Ye sawaal Dhanbad mein lift book karne se pehle har customer poochta hai — aur sahi bhi hai. Bank More mein naya G+3 makaan ban raha ho, Saraidhela mein building almost ready ho, ya Bartand mein purane ghar mein lift lag rahi ho — timeline ka saaf andaza hona chahiye taaki aap apna construction, griha-pravesh, ya kirayedaar ka plan usi hisaab se bana sako.
Seedha jawab: naye makaan mein booking se lift chalu hone tak aam taur par 10 se 16 hafte (2.5–4 mahine) lagte hain, aur purane ghar ke retrofit mein 8 se 14 hafte. Par ye timeline 6 alag-alag phases mein bat-ti hai — aur har phase mein aapka bhi ek role hai. Hum Cmax Engineering (Dhanbad ki lift company) is blog mein wahi poora process khol kar samjha rahe hain jo hum har customer ko booking ke din samjhate hain: har phase mein kya hota hai, kitna time lagta hai, delay kahan hota hai, aur aapko kya-kya karna hai. Sab timelines typical/indicative hain — aapke project ka exact schedule free site survey ke baad milta hai.

Poori timeline ek nazar mein — 6 phases
Pehle poora map dekh lijiye, phir har phase detail mein:
- Phase 1 — Site survey aur quotation: 3–7 din
- Phase 2 — Booking aur drawing approval: 1–2 hafte
- Phase 3 — Civil work (shaft, pit): 3–6 hafte
- Phase 4 — Lift manufacturing: 6–8 hafte (civil ke saath parallel chalti hai)
- Phase 5 — Installation: 2–3 hafte
- Phase 6 — Testing, inspection aur handover: 3–7 din
Kul: 10–16 hafte. Sabse important baat — Phase 3 (civil) aur Phase 4 (manufacturing) ek saath chalte hain, isliye manufacturing ka time alag se nahi judta. Yahi wajah hai ki experienced company chun-na time bachata hai: planning sahi ho to koi phase doosre ka intezaar nahi karta.
Phase 1: Site survey aur quotation (3–7 din)
Sab kuch yahin se shuru hota hai. Humari team aapke site par aakar ye check karti hai:
- Shaft ki jagah — kitni jagah available hai, kis floor par door kahan khulega
- Structure — naye makaan mein drawing ke hisaab se, purane ghar mein physical assessment
- Pit ki depth possible hai ya shallow-pit technology chahiye
- Bijli — single-phase ya three-phase, sanctioned load kitna hai
- Upar headroom aur machine ke liye jagah
Survey ke 2-3 din ke andar aapko likhit quotation milti hai — lift unit ka rate, civil work ka scope, electrical requirement, payment schedule, aur tentative timeline, sab ek document mein. Tip: Jo dealer bina survey ke phone par hi “₹X lakh mein ho jayega” bol de, usse savdhaan raho — bina dekhe diya gaya rate baad mein badalta hai. Quotation mein kya-kya dekhna hai, ye price guide mein detail mein samjhaya hai.
Phase 2: Booking aur drawing approval (1–2 hafte)
Quotation approve hote hi booking hoti hai — aam taur par 20-30% advance ke saath (Sample practice; company ke hisaab se alag ho sakta hai). Iske baad:
Technical drawings banti hain: Shaft ka size, pit ki depth, har floor par door opening ki position, machine ki jagah, electrical points — sab kuch millimeter-level drawing mein. Ye drawings aapko aur aapke mistri/contractor ko milti hain.
Aapka approval: Drawings par aap sign karte hain — iska matlab civil work bilkul isi drawing ke hisaab se hoga. Is step mein jaldbazi mat kijiye: galat drawing par bana shaft baad mein todna padta hai, jo sabse mehnga delay hota hai. Door kis side khulega, cabin ka size, har floor par landing — sab abhi final kar lijiye.
Manufacturing order: Aapke approval ke saath hi factory mein aapki lift ka manufacturing order lag jata hai — Phase 4 yahin se shuru ho jata hai, civil work ka intezaar kiye bina.

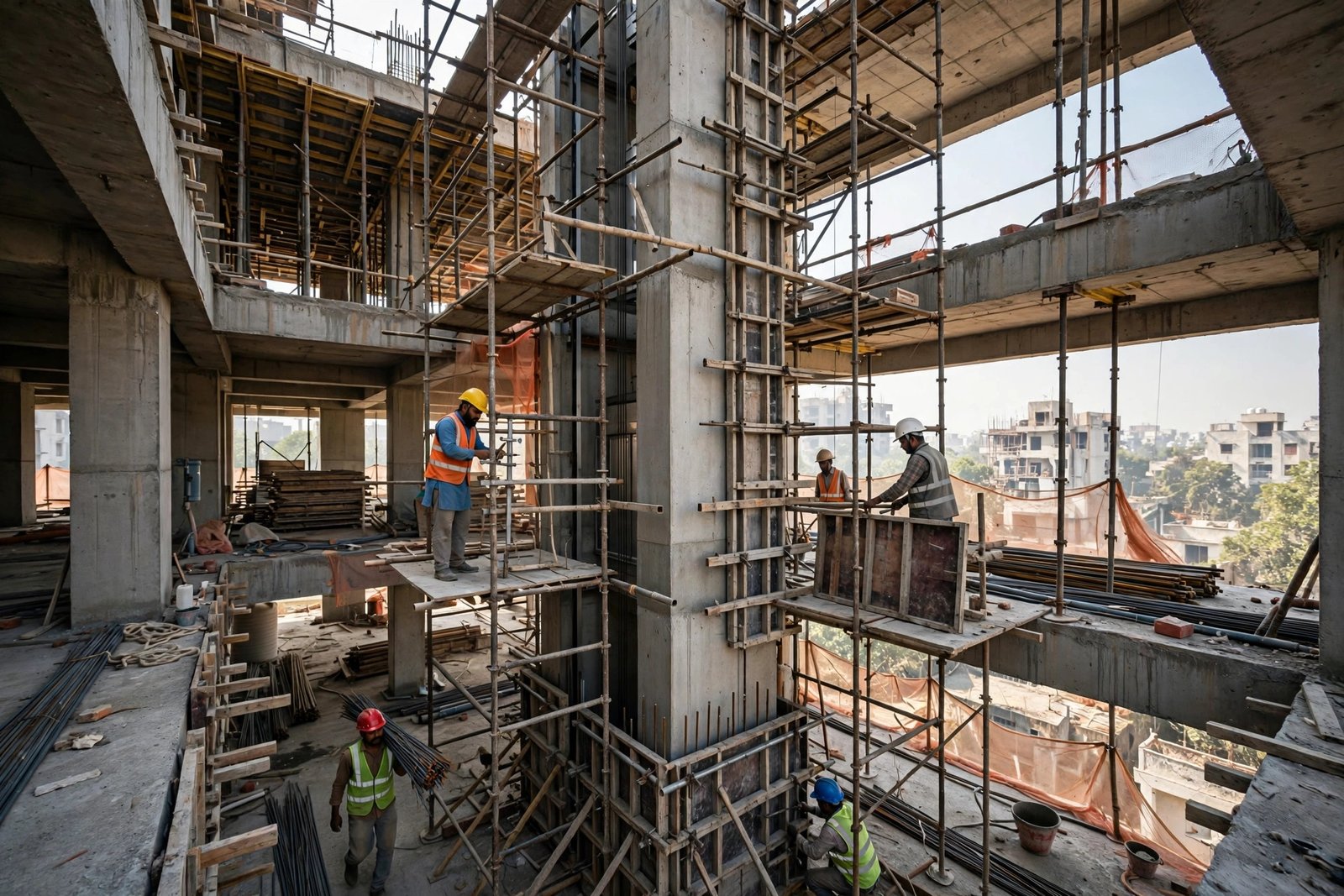

Phase 3: Civil work — shaft, pit, machine room (3–6 hafte)
Ye wo phase hai jismein sabse zyada delay hota hai — aur iska control aksar aapke contractor ke haath mein hota hai, lift company ke nahi. Isliye is phase ko samajhna sabse zaroori hai:
Pit: Zameen mein 4-5 feet gehri khudai (conventional lift ke liye), usmein waterproofing aur drainage. Dhanbad mein monsoon ke time pit mein paani bharna aam problem hai — monsoon care guide mein iska detail diya hai. Pitless/shallow-pit hydraulic lift mein ye step almost skip ho jata hai. Time: 1–2 hafte.
Shaft: RCC ya brick ka shaft har floor tak — deewarein, har floor par door opening. Shaft ka andaruni size drawing ke hisaab se exact hona chahiye; 2 inch ka farq bhi installation mein problem karta hai. Time: 2–4 hafte.
Machine room (agar chahiye): Conventional traction lift mein shaft ke upar machine room; MRL ya hydraulic mein nahi chahiye — isliye MRL lift naye gharon mein time bachati hai. Time: 1–2 hafte (agar applicable ho).
Electrical: Shaft tak three-phase/single-phase line, earthing, aur machine room tak wiring. Ye lift installation se pehle ready hona chahiye. Time: 3–5 din (electrician ka kaam).
Delay se bachne ke liye: Civil work shuru hone se pehle apne contractor ko approved drawings de dijiye, aur hafte mein ek baar measurement verify karwaiye. Humari team civil work ke dauraan 1-2 baar site par aakar measurement check karti hai — ye service booking mein shamil hai.

Phase 4: Lift manufacturing (6–8 hafte, civil ke parallel)
Jab aapka civil work chal raha hota hai, tab factory mein aapki lift ban rahi hoti hai. Ismein ye sab hota hai:
- Cabin: Aapke chune hue design, size aur finish ke hisaab se — SS, glass, ya designer panels
- Doors: Har floor ke landing doors + cabin door (automatic ya manual)
- Drive system: Motor, controller, VFD, ARD — aapki technology ke hisaab se
- Rails, counterweight, ropes/belts: Shaft ki height ke exact measurement par
- Factory testing: Dispatch se pehle har unit ka load test
Phir packing aur transport — factory se Dhanbad tak aam taur par 3-7 din lagte hain. Important: Manufacturing ka order Phase 2 mein hi lag jata hai, isliye ye 6-8 hafte civil work ke 3-6 hafton ke saath overlap hote hain — kul timeline mein extra nahi judte. Par agar aap booking mein der karte hain aur chahte hain ki “civil ready hai, lift kal lag jao” — to aisa nahi hota. Isliye lift ki booking civil work shuru hone se pehle karwa lijiye — ye sabse bada time-saving tip hai.
Phase 5: Installation (2–3 hafte)
Lift site par pahunchte hi humari installation team kaam shuru karti hai. Din-ba-din kya hota hai:

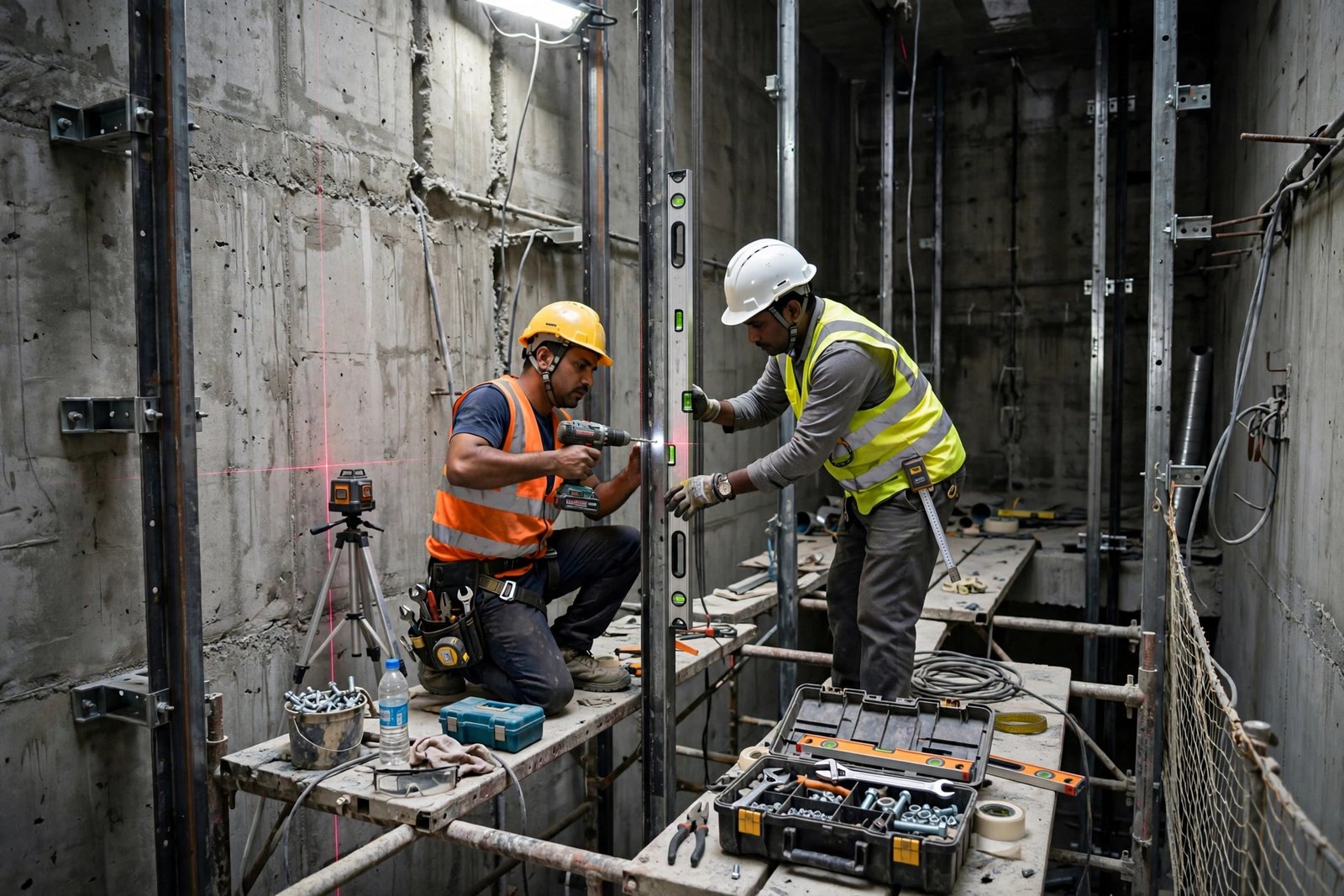

Hafta 1 — Structure: Shaft mein guide rails lagna (ye lift ki “patri” hai — iski alignment millimeter-perfect honi chahiye), counterweight frame, door frames har floor par. Ye sabse technical kaam hai — rail ki thodi si tedhapan lift mein jerk ya awaaz paida karta hai.
Hafta 2 — Machine aur cabin: Motor/drive ki fitting, controller aur wiring, cabin ka assembly, landing doors ki fitting aur adjustment. Bijli ka connection isi hafte mein test hota hai.
Hafta 3 — Finishing: Cabin ke interiors, light-fan, floor indicators, emergency systems (ARD, alarm, intercom), aur poori wiring ki checking.
Installation ke dauraan shaft ke aas-paas thoda shor-dhool hota hai, par rehte hue kaam ho jata hai — parivaar ko shift hone ki zaroorat nahi. Purane ghar ke retrofit mein installation ka yehi pattern hota hai, bas civil work ka nature alag hota hai (detail retrofit guide mein).
Phase 6: Testing, inspection aur handover (3–7 din)
Lift lagne ke baad turant “chalu” nahi ki jati — pehle testing hoti hai:
- Load test: Rated capacity ka wazan rakh kar upar-neeche — safety gears, brakes sab check
- Safety devices test: ARD (power cut simulation), emergency alarm, door sensors, overload indicator
- Speed aur leveling: Har floor par cabin bilkul level par rukni chahiye — 5mm se zyada farq nahi
- Trial run: 2-3 din ka trial — is dauraan chhoti adjustments hoti hain
Testing pass hone ke baad handover: aapko operation samjhaya jata hai (emergency mein kya karna hai, daily check kya hai), warranty papers aur AMC options diye jate hain. Jharkhand mein lift ka license/registration bhi hota hai — uski process hum guide karte hain. Warranty ke baad ka kharcha samajhne ke liye AMC guide zaroor padhein.
Timeline comparison — naye ghar vs purana ghar vs stair lift
- Naya construction (G+2/G+3, MRL/traction): 10–16 hafte — civil work drawing se pehle plan ho to sabse smooth
- Purana ghar retrofit (hydraulic/MRL): 8–14 hafte — civil work kam hota hai, par structure assessment mein time lagta hai
- Stair lift: 2–4 hafte — koi civil work nahi, sirf rail fitting; sabse fast option (stair lift guide)
- Hospital/commercial lift: 14–20 hafte — badi capacity, zyada floors, zyada approvals (hospital lift guide)
*Sabhi timelines typical/indicative hain — actual schedule site condition, technology aur approvals par depend karta hai.
Delay ke 5 common kaaran — aur unse kaise bachein
1. Civil work drawing se alag hona: Sabse common delay. Shaft ka size 2 inch chhota nikal aaya to deewar todni padegi. Bachav: Approved drawings contractor ko dein, aur humari team se mid-work measurement check karwayein.
2. Booking mein der: “Civil ho jaye phir lift book karenge” — is soch se 6-8 hafte ka manufacturing time baad mein jud jata hai. Bachav: Civil shuru hone se pehle book kar dein; manufacturing parallel chalegi.
3. Payment delay: Stage-wise payment rukne par manufacturing ya dispatch ruk jata hai. Bachav: Payment schedule pehle se clear rakhein — quotation mein likha hota hai.
4. Monsoon mein civil work: Dhanbad mein July-September mein pit mein paani, shaft mein seelan — civil work slow hota hai. Bachav: Monsoon se pehle pit ka kaam nipta lein, ya monsoon ke baad schedule karein.
5. Bijli ka intezaar: Installation ready hai par three-phase connection ya load enhancement pending hai. Bachav: Bijli ka application Phase 2 mein hi laga dein — JBVNL ka process apna time leta hai.
Aapka checklist — har phase mein aapko kya karna hai
- Phase 1: Site survey ke liye time dein; apni zaroorat saaf batayein (kitne log, kitne floor, budget range)
- Phase 2: Drawings dhyaan se check karke approve karein — door position, cabin size abhi final
- Phase 3: Contractor ko drawings dein; bijli ka application lagayein; mid-work measurement check karwayein
- Phase 4: Cabin ka design/finish select karein; stage payment time par karein
- Phase 5: Site par bijli aur paani available rakhein; installation team ko access dein
- Phase 6: Testing mein maujood rahein; operation aur emergency procedure seekhein; AMC decide karein
FAQs — Lift Installation Timeline
Q1. Booking ke baad lift chalu hone mein kitna time lagta hai?
A. Aam taur par 10–16 hafte (naye makaan mein) ya 8–14 hafte (purane ghar ke retrofit mein). Stair lift mein sirf 2–4 hafte lagte hain.
Q2. Kya lift ki manufacturing aur civil work ek saath ho sakte hain?
A. Haan — aur aisa hi hona chahiye. Booking ke saath hi factory order lag jata hai, jo civil work ke saath parallel chalta hai. Isliye civil shuru hone se pehle booking karwana sabse bada time-saver hai.
Q3. Sabse zyada delay kis phase mein hota hai?
A. Civil work mein — aksar drawing se alag construction ya monsoon ki wajah se. Approved drawings aur mid-work measurement check se ye delay avoid hota hai.
Q4. Kya rehte hue ghar mein installation ho sakti hai?
A. Haan. Installation mein thoda shor-dhool hota hai par parivaar ko shift hone ki zaroorat nahi padti.
Q5. Handover ke baad kya milta hai?
A. Testing reports, warranty papers, operation training (emergency procedure samet), aur AMC ke options. Jharkhand mein lift registration ki process bhi guide ki jati hai.
Q6. Monsoon mein lift installation karwana sahi hai?
A. Installation (machine fitting) monsoon mein ho sakti hai, par pit aur civil work monsoon se pehle nipta lena behtar hai — Dhanbad ki baarish mein pit mein paani bharna aam hai.
Free site survey — aapke project ka exact schedule
Is blog se aapko process to samajh aa gaya — par aapke ghar ya building ka exact timeline site dekh kar hi ban sakta hai: kitne floor, kaisi structure, kaunsi technology. Hum Dhanbad mein free site survey karte hain — survey ke saath aapko phase-wise schedule aur likhit quotation dono milte hain.
Call ya WhatsApp karein: +91 95349 06139 — Cmax Engineering, Dhanbad. Ranchi aur Bokaro mein bhi survey available hai.
